Brief project description
-
KOSTT (Kosovo*)
The project consists of the extension of SS Prizreni 2 (actual voltage 220/110 kV) to the new Prizreni-4 at the 400 kV voltage level and the construction of the new 400 kV interconnection between Albania and Kosovo. The Project includes the following actions on the Kosovar side:
- Construction of SS Prizreni 4 (Nashec), 400/110 kV with one 300 MVA autotransformer, which contains two 400 kV line bays, one 400 kV bus-coupler bay, one 400 kV and one 110 kV transformer bay;
- Expansion of the 110 kV busbar system;
- Construction of the switchyard Gjakova, 400 kV with four 400 kV line bays and 400 kV bus coupler bay;
- Construction of the 400 kV single circuit line, 31.5 km SS Gjakova - SS Prizren 4 (Nashec);
- Construction of the single circuit line SS Gjakova - SS Peja 3 with a length of 35.5 km;
- Construction of the second interconnection line 400 kV SS Nashec - SS Fierza with a length of 70 km (45km in Kosovo and 25km in Albania);
Based on the Energy Strategy 2022-2031, the transmission system of Kosovo should support the integration of more than 1.4 GW in the RES capacity, mainly solar and wind power plants. To achieve the objectives of the Energy Strategy and the National Energy and Climate Plan regarding the electricity sector decarbonisation, reinforcement and reconfiguration of the 400 kV network, new 400 kV interconnectors are needed to accommodate the increased level of additional generation sources, thus creating also further electricity exchange opportunities. In this aspect, the current 220 kV interconnection Fierza – Prizren 2 is often subject to congestions and represents a bottleneck in the network. The new project will reduce the loading of 220 kV line Fierza – Prizren 2, enhance the role of the existing 400 kV interconnection Koman – Kosova B, and together with the new 400 kV interconnection enable the grid integration of large amounts of RES capacities in the power system. The same intense integration of new RES is also foreseen in the Albanian power system. Furthermore, the new submarine 400 kV cable between Albania and Italy which is in the OST plans will enable a new 400 kV corridor which will be used for power exchanges between the regions and will give a positive signal on new investments in RES, market integration, and exchange of power regulation/control reserves so much needed for RES successful integration.Main benefits of this project include:
- Enables the support of new generation capacities from RES;
- Improving the reliability of the regional network, the general security of supply and flexibility in the operation of the power system;
- Increasing the value of the Net Transfer Capacity (NTC) between OST and KOSTT, allowing the increase of energy exchange between neighboring countries;
- Increasing commercial exchanges with Albania and other regional countries and the potential to develop a competitive regional energy market, and integration in pan-European electricity market;
- Helping in the gradual decrease of the role of the internal 220 kV network of the country;
- Enables the reconfiguration of the 110 kV network with the aim of optimizing power flows as well as optimizing the operational conditions of the transmission system.
-

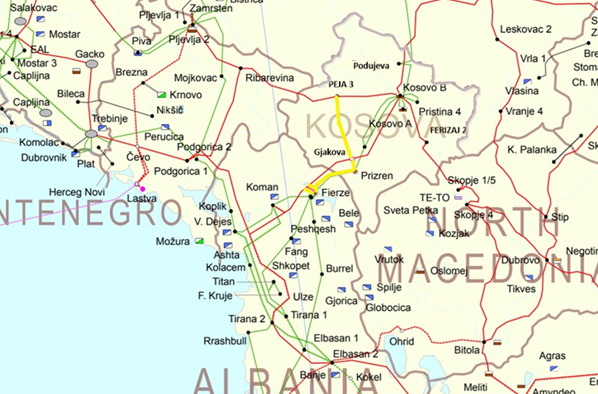

E06 project map
-
OST (Albania)
On the Albanian side, the project consists of the extension of SS Fierza to 400 kV level and the construction of the new 400 kV interconnection between Albania and Kosova. The Project will include the following actions:
- construction of a new 400/220/110 kV substation near the existing Fierza substation;
- installation of a 400/220kV, 600 MVA phase shift transformer - PST;
- reconfiguration of the 220 kV and 400 kV lines that will be connected to this substation;
- connection to existing interconnections 400 kV Koman – Kosova B and 220 kV Fierza – Prizren2;
- connection to the 110 kV transmission grid in the area;
- construction of the new 400 kV interconnection line between the new 400/220 kV SS Fierza and the new 400 kV SS Prizren4 in Kosova;
There are currently more than 1.3 GW of wind power plant applications in the northeastern region of Albania, and there is a need to accommodate this increased level of additional generation and create further energy exchange opportunities. In this aspect, the current 220 kV interconnection Fierza – Prizren 2 is often subject to congestion and represents a bottleneck element. This project will reduce the loading of 220 kV line Fierza-Prizren 2, enhance the role of the existing 400 kV interconnection Koman-Kosova B and, together with the new 400 kV interconnection with Kosovo, enable the grid integration of large amounts of wind power plant generating capacity.
The main benefits of this project include:
- Improving the reliability of the regional network, the general security of supply and flexibility in the operation of the energy system;
- Increasing the value of the Net Transfer Capacity (NTC) of the Albanian network, allowing the increase of energy exchange between neighbouring countries;
- A better distribution of the electricity produced by HPP Fierze and other HPPS on the Drin river cascade in the 400 kV network;
- Increasing commercial exchanges with Kosova and the potential to develop the regional energy market;
- Improvement of quality indicators and further utilization of the 400 kV interconnection network through redirection of energy flows;
- Helping in the gradual decrease of the role of the internal 220 kV network of the country;
- Supplying the increasing electricity demand of the Prizren area.
-
Basic project data
Descriptions Kosovo* Albania Project promoter company/Organization full name Shareholders of the project promoter company
Project impact as described by the project promoters The project will positively impact the increase of NTC between Kosovo and Albania and the integration of RES in both power systems.
Is the project cross-border? YES Is the project internal (national) and has a cross-border impact? YES Project ID in ENTSO-E TYNDP 2022: - Project ID in ENTSO-E TYNDP 2024: - Was the project included in any of the previous PECI processes? NO
Project in National Network Development Plan (NNDP): NO Project Name in National NDP / Infrastructure Plan: N/A Full name of the NNDP: N/A National NDP/infrastructure plan publication website N/A Are there any other internal or cross-border projects depending on the realisation of the project? NO Any other important/relevant information: N/A -
Technical data
Basic technical data Eligible electricity infrastructure type: Interconnector and internal network reinforcements Type of investment: Construction of new infrastructure Expected year of commissioning: 2030 Expected lifetime (years): 40 Substation from: Fierza (Albania) Substation to: Prizren-1 (Kosovo) Nominal voltage (kV): 400 Single/double circuit: Single-system circuit Maximum capacity (MW): 1080 Nominal apparent power (MVA): 1350 Length (km): 45 (Kosovo); 25 (Albania) Expected positive influence on the power system stability: YES - transient stability, voltage stability and frequency stability
Any other important/relevant information: NO Expected net transfer capacities increase Time frame From country 1
To country 2
Capacity increase from country 1 to country 2 (MW)
Capacity increase from country 2 to country 1 (MW)
2030
XK - Kosovo
AL - Albania
500
500
2040
XK - Kosovo
AL - Albania
500
500
2050
XK - Kosovo
AL - Albania
500
500
Other data Line resistance R (pu): 0,0008409375 (Kosovo); 0,00048 (Albania) Line reactance X (pu): 0,009646875 (Kosovo); 0,005413 (Albania) Line susceptance B (pu): 0,2421792 (Kosovo); 0,143018 (Albania) Number of additional substations: 2 (Kosovo)l 1 (Albania) Location of the additional substations: Prizren and Gjakova (Kosovo); Fierza (Albania) Capacity of substations (MVA): 300 MVA (Kosovo); 600 MVA (Albania) Voltage (kV): 400/220/110 kV Planned outage rate, if applicable (%): not available Forced outage rate, if applicable (%): not available Mean time to repair (h): not available Any other important/relevant information: no additional information -
Cost data
CAPEX (real 2022 million EUR)* Year Kosovo* Albania Total 2022
-
-
-
2023
-
-
-
2024
-
-
-
2025
1,2
0,7
1,9
2026
1,2
0,7
1,9
2027
0,4
0,2
0,6
2028
25,1
14,2
39,3
2029
25,1
14,2
39,3
2030
-
-
-
2031
-
-
-
2032
-
-
-
2033
-
-
-
2034
-
-
-
2035
-
-
-
2036
-
-
-
2037
-
-
-
2038
-
-
-
2039
-
-
-
2040
-
-
-
2041
-
-
-
2042
-
-
-
2043
-
-
-
2044
-
-
-
2045
-
-
-
2046
-
-
-
2047
-
-
-
2048
-
-
-
2049
-
-
-
2050
-
-
-
TOTAL
53,00
30,00
83,00
* As declared by the project promoters
OPEX (real 2022 million EUR)* Year Kosovo* Albania Total 2022
-
-
-
2023
-
-
-
2024
-
-
-
2025
-
-
-
2026
-
-
-
2027
-
-
-
2028
-
-
-
2029
-
-
-
2030
-
-
-
2031
-
0,01
0,01
2032
0,01667
0,01
0,02667
2033
0,01667
0,01
0,02667
2034
0,01667
0,02
0,03667
2035
0,03334
0,02
0,05334
2036
0,03334
0,02
0,05334
2037
0,03334
0,03
0,06334
2038
0,05001
0,03
0,08001
2039
0,05001
0,03
0,08001
2040
0,06668
0,04
0,10668
2041
0,06668
0,04
0,10668
2042
0,06668
0,04
0,10668
2043
0,06668
0,04
0,10668
2044
0,08335
0,05
0,13335
2045
0,08335
0,05
0,13335
2046
0,08335
0,05
0,13335
2047
0,08335
0,05
0,13335
2048
0,08335
0,05
0,13335
2049
0,08335
0,05
0,13335
2050
0,08335
0,05
0,13335
TOTAL
1,10022
0,69
1,79022
* As declared by the project promoters
-
Status data
Completed phases YES / NO Kosovo* Albania Consideration phase
YES
YES
Pre-feasibility study
NO
NO
Technical feasibility study
NO
NO
Economic feasibility study (Cost-benefit analysis)
NO
NO
Environmental impact assessment
NO
NO
Detailed design study
NO
NO
Resolved financing
NO
NO
Obtained approvals/permits
NO
NO
Approval by the regulatory authority(ies)
NO
NO
Final investment decision
NO
NO
Tendering procedure
NO
NO
Construction
NO
NO
Planned implementation schedule
Year Kosovo* Albania Consideration phase
-
Pre-feasibility study
-
Technical feasibility study
May/25
May/25
Economic feasibility study (Cost-benefit analysis)
May/25
May/25
Environmental impact assessment
May/25
May/25
Detailed design study
Dec/27
Dec/27
Resolved financing
Sept/25
Sept/25
Obtained approvals/permits
Jun/28
Jun/28
Approval by the regulatory authority(ies)
Dec/24
Dec/24
Final investment decision
May/25
May/25
Tendering procedure
May/27
May/27
Construction
Jun/30
Jun/30
Commissioning
Aug/30
Aug/30
Other data Does the project have a significant environmental impact: NO A brief description of the nature of the impact: A full ESIA/EIA study report is predicted to be carried out for this purpose. It will identify all the potential impacts and risks and will recommend appropriate mitigation measures. If the project was included in previous PECI lists, description of the actions taken since inclusion in the list: Detailed design study, Environmental impact assessment, Technical feasibility study, CBA
The major risk/barriers affecting the project implementation: - Economic risks related to the post-Covid economic situation.
- Financial risks: Transmission fee approval below the tariff needed.
- Financial risks: Delay payments on energy-transmitted bills from connected parties.
- Possible social impact from the expropriation process.
- Environmental risks: delay on receiving necessary permissions and environmental impact in the area where the line corridor will pass.
- Implementation risks: delay on possible expropriation process and project costs increase due to the energy crisis as well as high prices on raw material markets, such as steel.
Risk/barriers mitigation measures: - Economic risk severity is low as KOSTT and OST financial incomes are not affected by this situation.
- The cost-reflective (Kosovo) or correct (Albania) tariff methodology to be interpreted and applied by regulatory institution.
- Development of economic and financial analysis, which will include transmission tariff study and risks/sensitivity analyses and possible mitigation measures for it.
- Early intervention on environmental procedures.
- Cautionary measures are taken to avoid protected areas in the way of the line corridor and every possible deforestation is properly refinanced through a dedicated fund.
- Early intervention on expropriation procedures.
Is the investment project already applied for financing? YES (WBIF in 2024) If financial support has been already granted, the amount of support (in real 2022 million EUR): WBIG Operational Board decision still pending (February 2025)
If financial support has already been granted, the source of financing: N/A
Other information regarding the current project status: N/A
-
Contact data
Kosovo* Albania Contact name:
Gazmend Kabashi
Ganc Sejdiu
Altin Uka
Joana Nano
Organisation:
KOSTT
KOSTT
OST sh.a.
OST sh.a.
Country:
Republic of Kosovo
Republic of Kosovo
Albania
Albania
Position:
Office menager : Long Term Planning and Development
-
Director of Transmission Planning and Development Directory
Chief of Staff
-
Results of the evaluation (CBA analysis)
Calculated project benefits
Specific criteria
Indicator
Unit
2030
2040
2050
Market integration
B1. Socio-economic Welfare
mil EUR/yr
7.07
-5.82
2.45
Sustainability
B2, Additional societal benefit due to CO2 variation
Tons/yr
48,846
-14,861
0
mil EUR/yr 3.69
-5.20
0
Energy efficiency
B5. Variation in Grid Losses
MWh/yr
15,242
16,837
18,599
mil EUR/yr 1.26
1.64
0.95
Security of Supply
B6. Security of Supply: Adequacy
MWh/yr
-
-1,710
46,450
mil EUR/yr -
-1,710
46,450
Security of Supply
B6. Security of Supply: Adequacy
mil EUR/yr CBA results
Economic indicator
Unit
Result
NPV
mil EUR
226.02
B/C
-
